The Minety BESS project comprises two phases: Phase 1, an existing 99.8 MW installation, and Phase 2, a proposed 49.9 MW extension connecting to the 132 kV network.

Lightning bolt icon
Power Systems
Charging battery sector icon
Battery Energy Storage
Location pin icon
Minety, UK
Client icon
Confidential
Hero Image
Project Overview Image

Project Overview

Grid code compliance

The Minety BESS project comprises two phases: Phase 1, an existing 99.8 MW installation, and Phase 2, a proposed 49.9 MW extension connecting to the 132 kV network.

Project Facts Image

Project Facts

Battery icon

Grid code compliance

Lightning bolt icon

Phase 1, an existing 99.8 MW installation

Gear with circular arrows icon

Phase 2, a proposed 49.9 MW extension connecting to the 132 kV network

Hand holding a leaf sustainability icon
Capacity
149.7MW
Electricity transmission tower icon
Connection
132 kV
Industrial factory icon
Department
Power Systems

DACI Scope of Work

Electrical power module icon
Load flow and Reactive power capability studies
Battery energy storage icon
IEC60909 Studies
Commercial building power supply icon
G5 Issue 5 Harmonic assessment
Computer monitor with security shield icon
P28 Assessment
Lightning bolt energy icon
G99 RMS Dynamic simulation
Connected network nodes icon
Protection co-ordination and Arc flash

Critical Obstacles

High fault levels, uncertain long-lead protection requirements, and a compressed decision timeline meant technical justification was needed well ahead of the design being fully developed.

01

Critical Risk High SLG Fault Levels

High single-line-to-ground fault levels raised fundamental questions over the Phase 2 extension's earthing requirements, needing firm technical confirmation before procurement could proceed.
02

High Priority NER Requirement Uncertainty

The client needed clear technical confirmation and confidence on whether Neutral Earthing Resistors were required, ahead of a long-lead procurement decision.
03

High Complexity POW CSD Justification

The necessity of Point-on-Wave Controlled Switching Devices on the 132kV incomer breakers had to be established and technically justified.
04

Technical Depth Two-Phase Network Integration

Assessing an existing 99.8MW installation alongside a proposed 49.9MW extension at 132kV required consistent modelling across both project phases.
05

Non-Standard Compressed Long-Lead Decision Timeline

NER and POW CSD are long-lead delivery items, so the technical justification for each had to be established well ahead of the design being fully developed, rather than following the usual sequence.

DACI Solution

Eng response

To proactively address the project requirements, we engaged with the available technical information at an early stage and established the system model ahead of our usual modelling timeline. This allowed the engineering team to identify and assess the key technical requirements early, rather than waiting for the design to be fully developed.

Our internal design team was closely involved throughout the process, with direct collaboration between the modelling and design disciplines while the equipment specifications were being prepared. This ensured that the modelling assumptions, system requirements, and design specifications were aligned from the outset, enabling potential issues to be identified early and providing the client with greater confidence in the proposed requirement NER and POW CSD requirements.

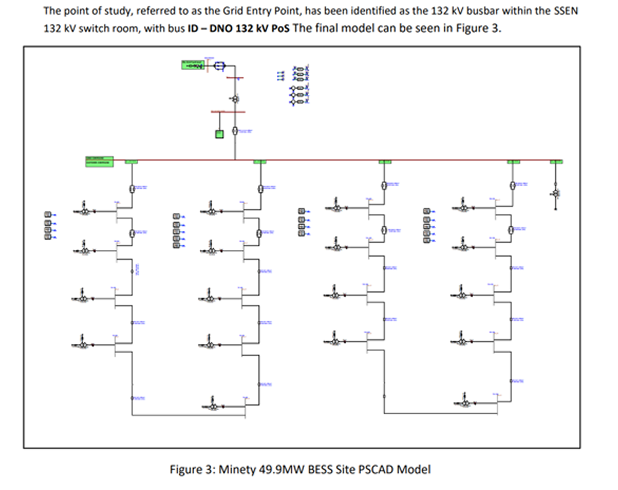

DACI Solution image
Outcome Image

Outcome

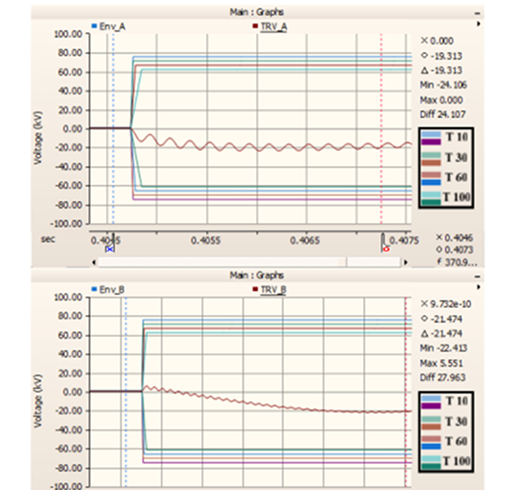

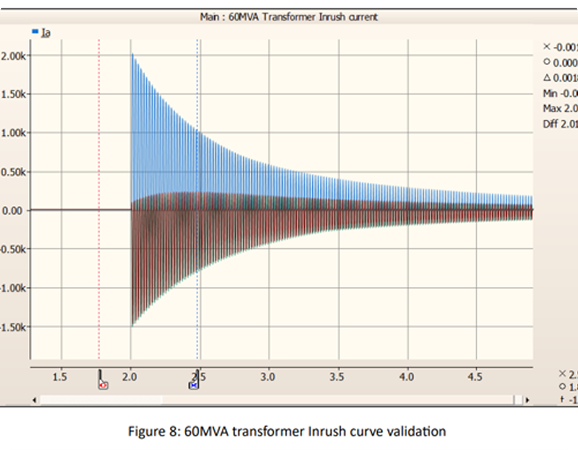

A detailed fast track modelling and studies were completed in 2 weeks that included IEC60909 assessment, NER assessment and P28 transformer energisation including the report which was used as an evidence to finalize the requirement of the NER and POW CSD. In addition to this, the team proactive took responsibility to finalize the specification of the earthing auxiliary transformer which is now in manufacturing. The remaining studies are in progress.

related case study

Substation & Transmission

Windyhill

DACI played a pivotal role in supporting Kirby's in the early stages of The Windyhill substation which is currently in the process of being retrofitted to a 275kV Substation.

Read Case Study
EV Charging Infrastructure

Milton Keynes

Design of a capacity-constrained EV charging scheme where the proposed charging infrastructure required significantly more power than the available network capacity.

Read Case Study
Solar & Storage

Long Pasture

DACI Utilities Engineering Consultancy delivered the civil and structural design for the 132 kV substation serving a combined solar and battery storage development at Long Pasture, near Darlington, County Durham.

Read Case Study

Ready to Build Your Next Critical Energy infrastructure project ?

Let's Collaborate deliver resilient, future ready solutions.

Get in Touch
Hands sketching architectural plans with pencil and ruler on a desk with calculator nearby.
